Project Milestones: Definition, Examples & How to Set Them

Lucija Bakić

Last updated Sep 27, 2026

Project milestones are the checkpoints where work gets approved, an invoice gets raised, and someone gets rebooked.

However, managing them in live projects can be quite challenging.

In this guide, you’ll get the definitions and examples first. After that, how to set project milestones with exit criteria and named owners. Then a six-week schedule where one gate releases an invoice and another frees a designer.

Last, milestone charts and the three options when a gate slips.

What Are Project Milestones?

A project milestone is a zero-duration checkpoint on a project timeline. It marks a phase closing, and it carries no hours and no cost of its own.

Project checkpoints like these break the project life cycle into stages. End to end project management runs from project initiation to project closure.

You should keep in mind that:

  • Not every date is a milestone.
  • The major milestones are the ones a client would name if asked where the work stands.
  • The significant events worth marking are the ones that change what happens next: an approval, a release, a handover.

Milestones vs. Tasks, Goals, and Deliverables

Project milestones, tasks, goals, and deliverables differ by duration and by what each one commits you to. A milestone is a moment and a task is work. A goal is the outcome, and a deliverable is what the client receives.

Project milestones sit on top of a network of tasks with allocated employees and costs. Project deliverables often land on a milestone date, though not always.

ElementDurationWhat it commits
MilestoneZeroA decision: a sign-off, an invoice, or a booking change
TaskStart and end dateHours, an owner, and a cost
GoalThe length of the engagementThe outcome you are measured on
DeliverableVariesThe artifact you hand over

How Does Tracking Project Milestones Keep Projects on Schedule?

Tracking project milestones works because each gate checks committed project objectives against actual delivery. It does that while corrective action is still cheap. A gate review covers three things:

  • Schedule: which dependent tasks moved, and whether the next gate date still holds.
  • Cost: hours logged and spend against the phase estimate, not the full project budget for the engagement.
  • Capacity: who was booked to start the day the gate cleared, and where they go if it slips.

For an agency running a campaign, that review is what catches a slip in time:

  • The copy approved milestone is three days late because client feedback has not landed.
  • Two designers were booked to start layout the moment it cleared.
  • The launch gate sits eleven working days out.

Spot it at the gate, not launch week, and those designers move onto other work for three days. The launch date holds.

Bookings in Productive’s Resource Planning make that collision visible before you pay for the bench time.

June 2023 schedule showing project milestones for Pink Flamingos and ADB Bank, with tasks and vacation days marked.

resource planning

Project milestones also give finance a number rather than a status color. Earned value management at gate level measures contracted value delivered against money spent.

Say the discovery gate closes at 180 hours against a 140 hour estimate. Margin is eroding a fifth of the way in. Reprice the remaining phases or raise a change request before the next two gates repeat it.

Project milestone status also changes what the client hears. Instead of a note that twelve of twenty tasks are done, they see which phase has cleared. They also see which one is waiting on them.

A milestone stuck at approval is also an invoice you cannot raise yet. That is the point where a completed gate becomes recognized revenue.

See What Moving a Milestone Costs You

Change one date and Productive shows the bookings it breaks, before anyone loses committed hours.

Book a demo

Practical Examples of Project Milestones

Practical milestone examples are approvals, releases, and handovers. Which ones you use changes with the type of work you deliver. These are the project management milestones each discipline tends to set:

  • Marketing project: project kickoff, copy approved, campaign launch, performance review, final campaign report.
  • Design project: initial concept approval, wireframe completion, prototype development, design sign-off, final delivery.
  • Software development or digital product agency: requirements gathering complete, technical spec approval, beta release, quality assurance testing passed, go-live.
  • Consulting: needs assessment, strategy proposal, mid-project review, final recommendations, post-completion support.
  • Construction project: site preparation, laid foundation, structural framework, building inspection, construction completed.

Each of these carries a consequence beyond the date.

A design sign-off releases the build team onto the work. User acceptance testing clears the go-live window. A strategy proposal decides whether the next phase is staffed at all.

The consulting example shows how that works when a milestone is treated as a formal gate. Say discovery surfaces a different problem than the one scoped, so the team reworks the strategy.

The mid-project review becomes the approval gate. The client reviews the revised plan and names what they are accepting. Signing off happens in writing before implementation work starts. If that approval is late, the implementation start date moves with it.

The value of the gate is what it prevents. Without it, the extra research days get absorbed into implementation and the engagement quietly drifts past its original scope. With it, they show up as a change order with a new fee and a new project end date.

How to Set Milestones in Project Management?

You set milestones in project management by assigning the responsible person, setting exit criteria, spacing intervals two to four weeks apart, then sharing the schedule. Below, we’ll break down each step in a repeatable process.

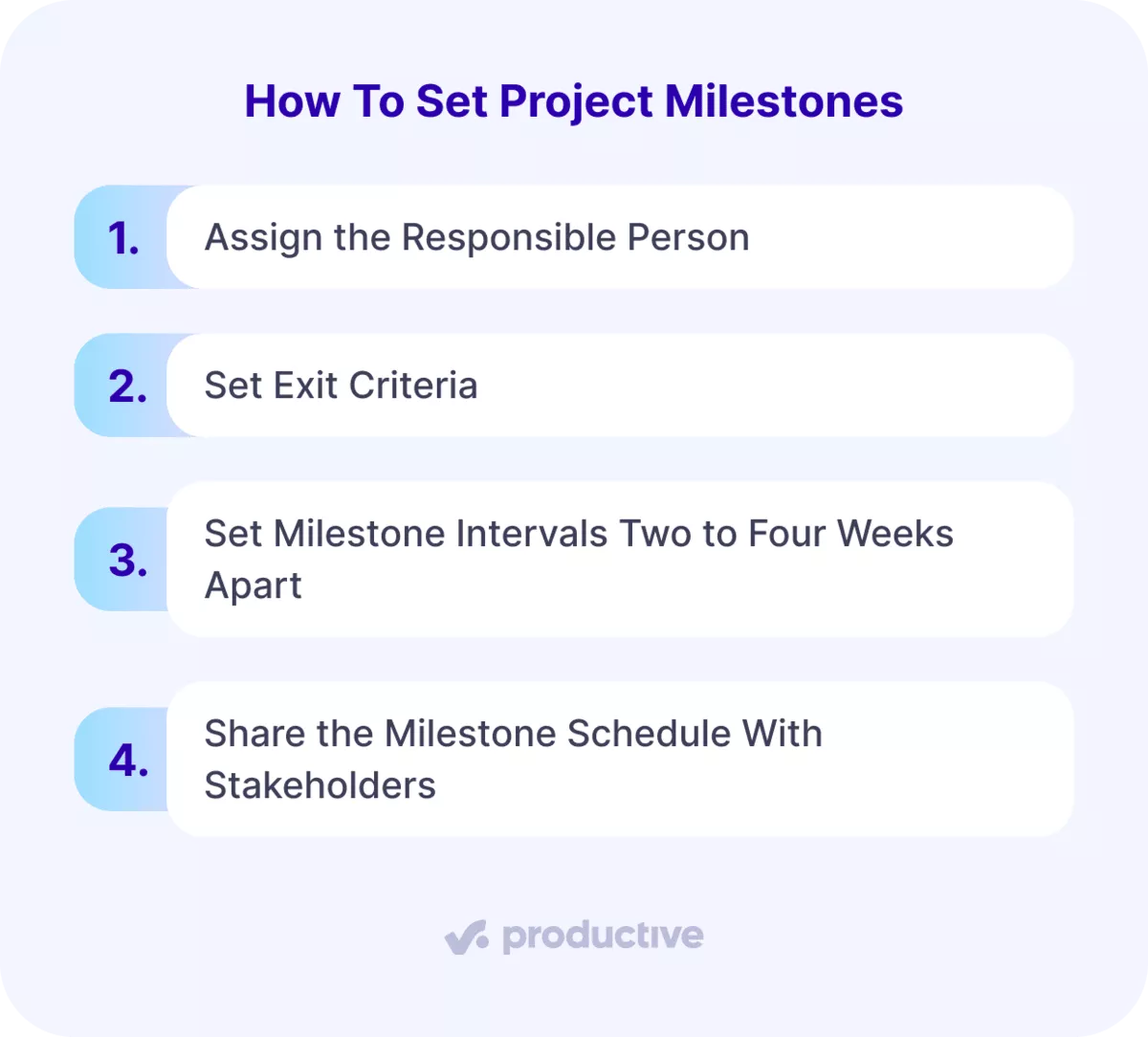

Guide on setting project milestones: assign roles, set criteria, schedule intervals, and share with stakeholders.

Step 1: Assign the Responsible Person

Assign one responsible person per milestone, named in the schedule, never a team. That person keeps the tasks behind the gate moving and decides when it has cleared.

It is often an Engineering or Design Lead. A project manager or account lead works better when the gate turns on client approval. Name task owners underneath, but keep one name on the gate itself. Two names on one milestone means neither of them chases it.

Step 2: Set Exit Criteria

Write the criteria before the phase starts: cost variance, schedule and scope at completion.

Make each criterion testable by a named person. “Wireframes approved” is a label. This is a criterion: all twelve screens reviewed, the client’s changes logged, and final design approval confirmed in writing. The owner can pass or fail that.

Put the phase’s hour and spend limits on the same list. A gate can then fail on an overspend, not only on missing work. Where a gate needs an external review, name who runs it.

Step 3: Set Milestone Intervals Two to Four Weeks Apart

Milestone planning works better from past data than from a calendar. Set the interval by how often the work changes direction, not by dividing the timeline into equal parts. Pull the last two or three projects of the same type and count the working days between client approvals.

A retainer build with a known client can sit at four weeks. A discovery phase with a new client sits at two. Check each gate date against the booking calendar. Widen or shorten the schedule intervals once you see which phases produce the churn.

Step 4: Share the Milestone Schedule With Stakeholders

Share the milestone schedule in the week the statement of work is signed, before anyone is booked. One list covers both audiences: every gate, its date, its owner, and what the client approves.

Stakeholders on the client side hold review dates in their own calendar instead of replying to email threads. Project teams get status updates naming the next gate rather than the next task. On a programme, publish the milestone schedules side by side. One stream’s project schedule then shows its effect on the others.

The schedule passes when every gate carries a client-side approver by name. Two milestones with the same owner in the same week is a fail. Move one.

Extra Advice: Set milestone dates against who is actually booked. Check every milestone against the booking calendar before the schedule reaches the client.

How Do You Visualize Milestones on a Gantt Chart?

A Gantt chart visualizes project milestones as markers on a horizontal timeline, above the bars that carry the work. Take a six-week brand redesign at a design agency.

The bars cover research, concept development, and production, while three diamonds mark the points where the engagement changes state:

  • Concept approval, end of week two, when the client picks a direction and the concept scope locks.
  • Design sign-off, end of week four. This gate releases the second invoice and frees the senior designer.
  • Final delivery, end of week six. The last milestone fee is released and the handover checklist for project closure opens.

Ask AI for business insights in Productive.

Read the chart at the Monday resourcing meeting, before anyone’s week gets committed. Project milestones are the only rows that matter in that ten minutes. Scan for any marker left of today’s date line with no completion mark.

That gate has passed on the calendar but not in reality. It needs a client call before the next phase starts consuming hours.

A screenshot of a software for project milestones displaying a progress chart for a "Rebranding Campaign." The chart tracks time and budget over weeks (W23 to W27), showing invoicing details and remaining work hours.

Manage the critical path of your project more easily.

Dependencies are what make the chart usable past week one. Every serious option among the tools built around the Gantt timeline supports them.

In Productive, the Move dependent tasks toggle shifts every downstream task when you change a check date. Bookings linked to those tasks move with them. A warning appears when the change would cost someone booked hours.

Check the effect in the Resource Planner before you confirm.

What Is a Project Milestone Chart?

A project milestone chart shows only the gates, stripped of the task bars underneath them. A Gantt chart answers what the team is doing this week. A milestone chart answers whether the engagement is where it should be.

That difference decides who you send it to. Clients and sponsors get the milestone chart. A row per task invites questions about work they are not paying to manage. Delivery leads keep the Gantt.

Build it from the same dates. Each of the project milestones becomes one marker with its date, its owner, and its status. Project phases that carry no gate do not appear. A six-week redesign that fills forty rows in a Gantt view fits in three markers here.

When two gates slide right in the same month, the problem is capacity or client response time. It is not the phase that missed. A single gate moving on its own is usually a scoping miss in that phase.

The same chart carries the key events a sponsor asks about. It shows when the main phases close and which phase milestones are still open.

To share this data, you can automate your sending with Productive’s Pulse (to Slack or email) or create custom dashboards and add specific reports with widgets.

With Productive’s Client Portal, you can also add clients to your boards and use permissions to control what users can see and do on the platform. This helps make feedback loops quicker and improves overall client relationships.

How Do You Report on Project Milestones?

Report on project milestones with a project progress report. It shows each gate, its owner, its approval status, and the invoice attached to it. Add budget burn at each gate. That catches a phase which has used most of its hours at the halfway point.

Automate the send with Productive’s Pulse, to Slack or email. Or build a dashboard and add the reports you want as widgets. Other platforms that report across every client handle the same job differently.

Bar chart shows project milestones profit, cost, and revenue for September and October 2021, highlighting financial trends.

Get instant reports on milestone completion and project progress.

The Client Portal adds clients to your boards. Permissions control what each person can see and do. A client who can see their own approval sitting nine days unanswered reads it differently. The response window becomes their problem too, not just a line in your status email.

We also love the ability to invite our clients into the projects. It’s great to have the ability to have your project managers and clients talk directly and not having to worry about catching up on emails at 8PM. This also lets the client see how much work is actually going into the project and you can see that they have a greater appreciation for what we do.

Alex Streltsov,
General Manager at Prolex Media

Learn how you can support your agency operations with Productive.

Another key thing to do after project completion is to hold a postmortem review. The useful version compares planned gate dates against actual ones. Sort each slip by cause: late client feedback, an underestimated phase, or scope added mid-milestone.

Why Do Project Milestones Fail?

Project milestones fail because quality goes unchecked at the gate, deadlines are set without a capacity check, and requirements shift mid-phase. The project carries too many gates, and stakeholders hear about progress only when they ask.

Teams treat the gate date as the finish line. Work ships without ever being checked against acceptance criteria. Subpar deliverables then surface at the next milestone, when rework costs more and the budget has already burned.

It’s kinda obvious, but you should always review the tasks behind the project milestone before you mark it complete.

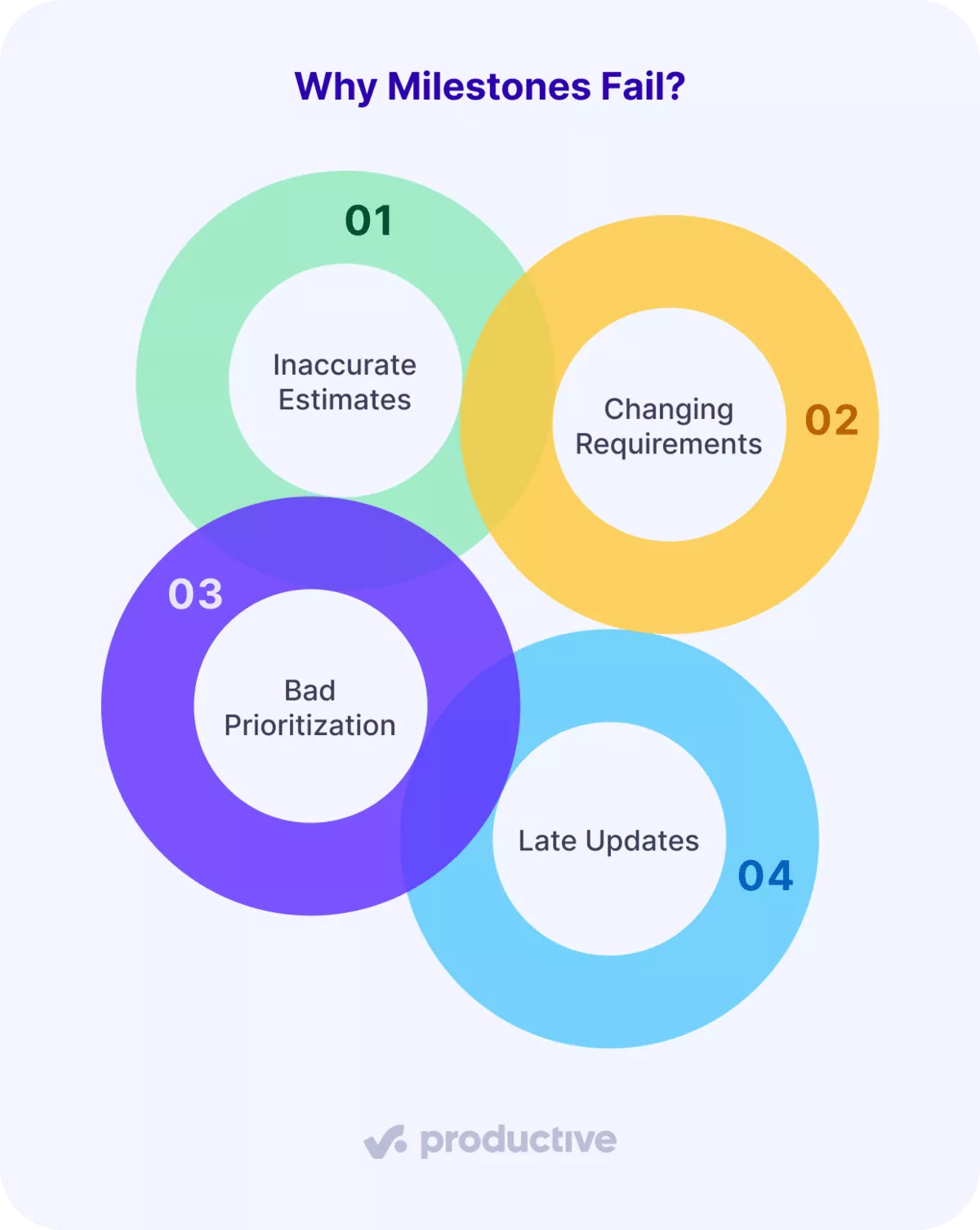

Four colored circles illustrate project milestones challenges: inaccurate estimates, changing requirements, prioritization, updates.

Reason 1: Inaccurate Estimates

Optimistic estimates happen when nobody checks how long similar phases actually took. The slip then lands on the milestone instead of on the estimate. Assume that what can go wrong will go wrong, and build contingency into each phase.

Reason 2: Changing Requirements

Requirements shift mid-phase because feedback arrives late and nobody wants to hold the client up. Set shorter project milestones and implement change once the current milestones close. A mid-phase change priced as its own budget leaves the original phase estimate intact to compare against.

Reason 3: Bad Prioritization

Too many project milestones make prioritization harder and leave the project team unsure which checkpoint matters. Milestone management gets easier when every gate carries a decision: an approval, an invoice, or a booking re-forecast.

Reason 4: Late Updates

Sporadic updates mean clients hear about progress only when they ask. Questions then arrive as email threads rather than against the work. Share project milestone status and budget burn on a fixed cadence, in one report.

That report is also the earliest place to catch scope creep in project management.

How Do You Recover Missed Project Milestones?

You recover missed project milestones in one of three ways. Move the date and rebook the project team, cut scope to hold the date, or raise a change order.

Pick by what is fixed on the project:

  • If the end date is contractual, cut scope from the phase.
  • If the deliverable cannot shrink, move the milestone and release the booked hours onto other project work.
  • If the slip came from new client requests, price it as a change order with a new date.

Make the call in the week the project milestone was due. Wait longer and the booked hours are already spent, which leaves you cutting scope or absorbing the overrun.

How Can Software Help You Track Milestones?

Software helps with milestone tracking when the milestone, its tasks, and its money sit on one project. Productive is one of ten project management tools compared here, and the all-in-one option among them.

Here’s how it helps with tracking and reporting:

  • In the Gantt layout, the Move dependent tasks toggle shifts every downstream task when you change a gate date.
  • Bookings linked to those tasks move with them. A warning flags the change before it costs booked hours.
  • A budget set up per phase tracks hours against that phase’s estimate. A time warning fires at a percentage you set.
  • Milestone billing runs as draft invoices dated to each gate, or as one budget per gate invoiced separately.

Without that, moving one project milestone takes three edits in three systems. The booking calendar is the one that stays wrong.

Above a single project, the same gates roll up into how budgets, bookings, and delivery connect across a portfolio. Book a demo to see it on your own projects.

Keep Milestones, Budgets, and Bookings on One Project

Track hours against each phase estimate, and raise the invoice the moment that milestone clears.

Book a demo

FAQ

What are milestones in agile project management compared to traditional project management?

In agile methodology, a milestone usually marks a sprint or a release. The set gets reassessed each iteration. In professional service project management, milestones are fixed at kickoff. The fee and the invoice schedule depend on them.

How can I prioritize milestones in a multi-phase project?

Use the critical path method to find the project milestones that block other phases. Then rank each one by what it holds up. A phase start, a client approval, or an invoice you cannot raise. Gates that hold up two of those come first.

What is the difference between a milestone and a deadline?

A deadline is the date one piece of work is due. A milestone is a date where the engagement changes state. Something gets approved, invoiced, or rebooked. Milestone goals sit above both. Every milestone has a deadline. Most deadlines are not milestones.

How do I handle milestone changes mid-project?

Tell every approver on the schedule, reassess the work plan, and move the bookings before you move the date. Then check which invoice was tied to the original gate, because that number moves with it.
